A straight tub swap is a two to three day job. Add new tile or a wall that has to come apart and you are looking at most of a week. Here is where every one of those days goes.
The Honest Answer, Day by Day
Most bathtub replacements take two to three working days when the new tub drops into the same opening. A full tub-and-surround rebuild with tile runs five to seven days, and the reason is grout and mortar curing, not slow work.
That range assumes the wall opens clean. On a bathtub replacement in an older home, the crew often finds soft framing or a drain that has to be rebuilt, and that adds a day before anything new gets set. The schedule below is what a normal job looks like.
What Happens on Each Day of the Job

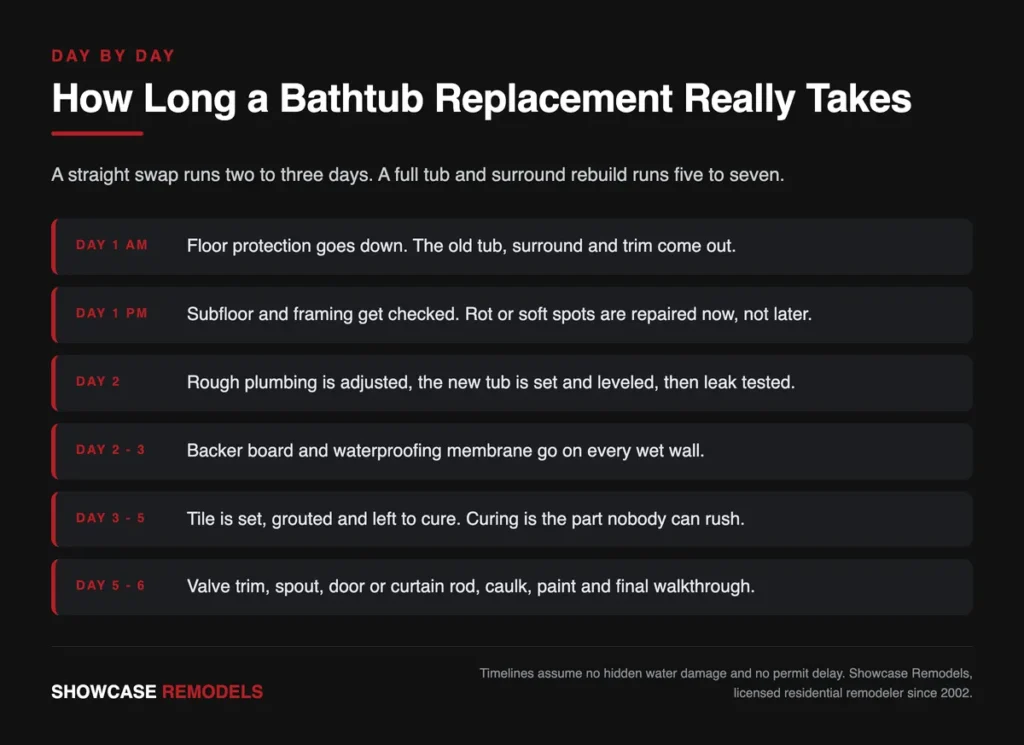

Day one: protection and demolition
Floors and stairs get covered, water is shut off, and the old tub, surround and trim come out. A cast-iron tub often has to be broken up in place to get it through the door.
Day one, afternoon: the reveal
With the walls open, the crew checks the subfloor, the studs and the drain. Rot gets cut out and replaced now. This is the step that decides whether the project stays on schedule.

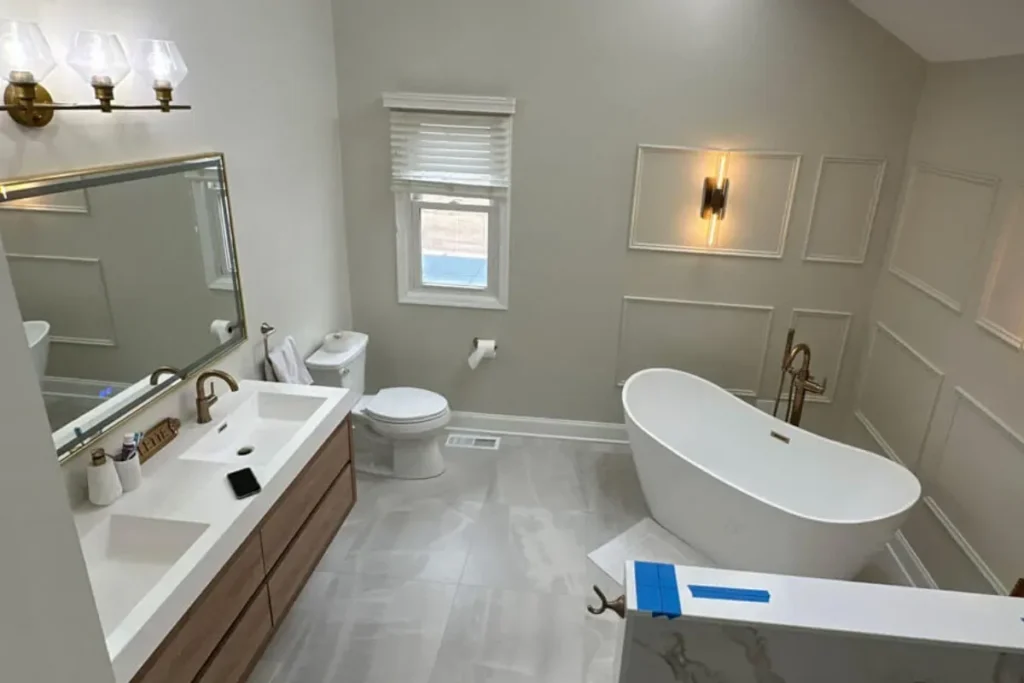

Day two: setting the tub
Rough plumbing is adjusted, the new tub is set in a mortar bed, leveled, connected and leak tested before anything covers it up.
Days two to three: waterproofing
Backer board goes up, then a bonded waterproof membrane across every wet wall and into the corners.
Days three to five: tile and cure
Wall tile is set, allowed to firm up, then grouted. The grout gets a full day before anyone touches it with a sealer or caulk gun.
Days five to six: trim and finish
Valve trim, spout, shower door or curtain rod, caulk lines, touch-up paint and a walkthrough with the homeowner. The room is usable again at the end of this day.nnnA crew that shows up on time and works the room straight through is what keeps that schedule real. Gaps between trades are what turn a five-day job into a three-week one.
Why Tile Adds Three or Four Days
Tile is not slow to install. It is slow to cure. Thinset mortar needs time to set before grout goes in, and grout needs time before sealer and caulk. Rushing either step is how you get hairline cracks along the tub line within a year.
The waterproofing underneath is the part nobody sees and the part that decides whether the tile lasts. The ANSI A118.10 standard for bonded waterproof membranes, maintained through the Tile Council of North America, requires the membrane to be continuous through every change in plane and to run from the drain to the full height of the tile. Corners and the tub-to-wall joint are where shortcuts show up.
An acrylic or solid-surface surround skips most of that curing time, which is exactly why a one-day tub-and-surround package is possible at all. You trade tile’s look and repairability for speed.
That trade is a fair one for a lot of households. A one-day system gets a rental unit back in service or gives a family with a single bathroom a working shower by dinnertime.
Tile is the better choice when the bathroom is the one you show people, when you want a custom niche or bench, or when a damaged section has to be repairable without replacing the whole wall.
What Quietly Adds Days to a Tub Replacement
Four things stretch the schedule more than anything else, and three of them are invisible until demolition day.
Hidden water damage
A slow leak behind an old surround softens the subfloor and the bottom plate. Cutting it out and re-framing is a day of work most quotes cannot predict.
Drain and vent rework
Older homes often have a drain that does not line up with a modern tub, or a vent that no longer meets code. Both have to be corrected before the tub is set.
Special-order tubs
A stock alcove tub is on the shelf. A freestanding or cast-iron tub can take weeks to arrive, so order lead time, not install time, becomes the real schedule.
Getting the tub into the room
A sixty-inch tub does not turn a tight corner. On a second-floor bathroom with a narrow stair, the crew sometimes has to bring it in before a door casing goes back on, which changes the order of the whole job.nnnShowcase Remodels crews work in a lot of older Philadelphia row homes, and one review from a Northeast Philadelphia homeowner put it well: they are very experienced with older homes and took care of everything from start to finish. That experience is mostly about expecting the surprise instead of being stopped by it.nnnOur estimators open the access panel and check the drain and overflow before quoting whenever a panel exists. A ten-minute look saves an argument later about what was and was not in the scope.
How to Keep Your Tub Project Short
Pick the tub before demolition starts and have it on site. Nothing wastes days like a crew waiting on a delivery with the wall already open.
Keep the tub in the same footprint if you can live with it. The moment the drain moves, the job crosses from a swap into a small remodel, with the framing and inspection that come with it.
If the bathroom is the only one in the house, ask about a same-day surround system. If you are on the fence about keeping a tub at all, our comparison of a walk-in shower versus a bathtub is worth reading first, and the full bathroom remodel timeline shows how a tub swap fits into a larger project.
Removing an old tub is also a safety decision. Bathroom injuries send hundreds of thousands of Americans to emergency departments each year, and the CDC reports that most of them happen in or around the tub and shower. A lower entry is not just a comfort upgrade.
Finally, book the job for a week when someone can be home. Decisions come up during demolition, and a homeowner who can answer a question in five minutes keeps the crew moving instead of standing still.
Frequently Asked Questions
Yes, when the new tub drops into the same opening and the walls get an acrylic or solid-surface surround instead of tile. Showcase Remodels runs a one-day service built around exactly that scope.
Plan on the room being out of service for the whole job, plus one extra day after the tile work for grout and caulk to cure. Water can usually stay on in the rest of the house.
Up front, yes. Reglazing buys a few years of cosmetic improvement but does nothing for a leaking drain or damaged framing. If the surround is coming off anyway, replacement is the better spend. Call 215-515-6484 to talk through both.
